Side profile of Nicollet Avenue bridge with the Midtown Greenway path going under, and a street sign saying Nicollet Ave mounted on the side of the bridge.

An Ode to the Nicollet Avenue Bridge Over the Midtown Greenway

On Tuesday, October 14, demolition of the Nicollet Avenue bridge over the Midtown Greenway started for the eventual replacement as part of the New Nicollet Redevelopment project. This made for an opportunity to document the bridge as it fades into memory, and discover more about it.

Bridge Construction and Characteristics

The bridge, formerly MnDOT bridge ID 90590, was constructed in 1914 as part of the Twenty-Ninth Street Railroad Depression project by The Chicago, Milwaukee and St. Paul Railroad, also known as the Milwaukee Road. The bridge served streetcars (until 1954), pedestrians, motor vehicles and other road users until its closure for the construction of the Lake Street K-Mart on July 1, 1977.

Looking south along Nicollet Ave with road closure and detour signs posted. The slight curve of the Nicollet Ave bridge is visible in the distance, and past it, the street lights are still up in the location where the Kmart will be built.
Road closure on Nicollet Avenue for construction of the Kmart store, likely summer 1977. Credit: Hennepin County Library.

Like the typical bridge on the corridor, the bridge was made of reinforced concrete for a slab and girder design and featured three spans supported by two concrete abutments and two sets of four piers. The bridge was built with a full-height retaining wall on the south side, and a half-height retaining wall on the north. This allowed for two tracks each under the south and center spans, and one track under the north span. The west side of the bridge had the standard decorative parapet while the east side had an atypical flat face, without a parapet at all, only featuring a metal railing. It’s unclear why this was the case and when the modification was made (but it was before the closure of Nicollet Avenue in 1977).

Advertisement

Along the railroad corridor, most of the typical three-span bridges were 49 or 51 feet wide, with the exception of five, which were wider to accommodate streetcar lines. These bridges include Cedar Avenue (60 feet), Bloomington Avenue (63 feet), Chicago Avenue (71 feet), Park Avenue (70.4 feet, built without featuring a streetcar line) and Nicollet Avenue (83 feet). This made the Nicollet Avenue bridge the widest of the 37 installed over the railroad tracks in the 1910s (however, it is outlived by the 1916 Bloomington Avenue bridge, which still stands). The piers for the bridge were noticeably farther apart, and were wider to accommodate the extra weight and load capacity of the bridge.

Many bridges, including Nicollet Avenue were first used with a sand bed covered with wood block pavers as a road surface, and only later replaced with asphalt or concrete. Another unique feature about the Nicollet Avenue bridge is that it was first built with five-foot removable sidewalk extensions on each side, covering the road bed to allow for later roadway expansion.

The article, Track Depression at Minneapolis, from Engineering News Volume 73, Number 11 (Mar. 18, 1915), described many of the engineering characteristics of the 29th Street track depression project in detail. It included the following paragraph about the Nicollet Avenue bridge and its unique sidewalk extensions.

A rather novel deck construction on the Nicollet Ave. bridge provides for a future widening of the present 50 ft. roadway to 60 ft. The concrete roadway deck is made 60 ft. wide, with 10-ft. sidewalks, but the latter are widened to 15 ft. by hollow tile blocks laid upon the roadway and covered with a thin layer of concrete. Whenever the city desires to widen the roadway, the 5 ft. of tiles can be removed readily, without affecting the structural design of the bridge.

Track Depression at Minneapolis, from Engineering News Volume 73, Number 11 (Mar. 18, 1915)

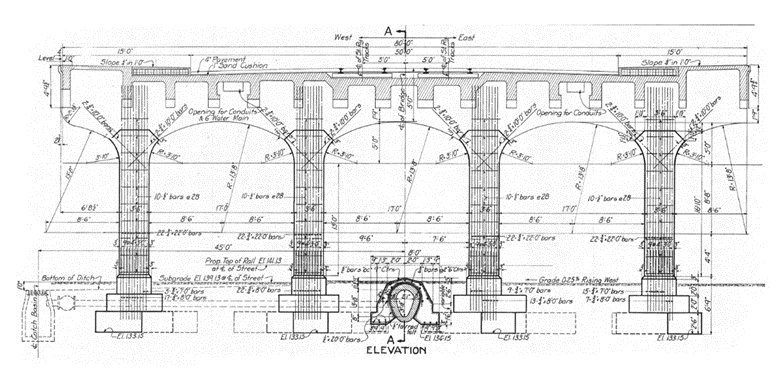

Design drawing of the Nicollet Ave bridge looking along the direction of the bridge. Measurements for the footings, piers, arches, deck, parapets, sewer, utilities, and other features are noted.
Design drawing of the Nicollet Avenue bridge. Note the sidewalk extensions over the roadbed and recessed streetcar tracks in the center. Credit: Published in Engineering News Volume 73, Number 11.

According to a recent bridge inspection report (and from estimating in photos) the bridge had 15 ft. sidewalks on each side of the bridge at the time of demolition. It’s unknown if the roadway was ever widened.

Advertisement

Changes

Streetcar service in Minneapolis ended in 1954, and the tracks were paved over with asphalt sometime after. The area around the bridge changed significantly in the 1960s and 1970s. The construction of I-35W largely displaced Black residents in this area in the 1960s. The Nicollet-Lake development was built in the mid-1970s which included raising several city blocks. Kmart was the anchor store of the development and gave the city an ultimatum to close Nicollet Avenue, or they would exit the deal.

1978 photo from perhaps 150 ft up, showing the new Kmart and other stores, severing Nicollet Ave. New multi-family housing is in the bottom of the image.
Nicollet-Lake Area, 1978. Credit: Hennepin County Library.

Amidst the changes and during a time of change for the neighborhood, the Whittier Alliance (now the official neighborhood organization for Whitter) was founded in 1977. 20 years later in 1997, they launched the branding for Eat Street, 17 blocks of Nicollet Avenue from Grant Street to 29th Street. The closure of Nicollet Avenue kept traffic north of 29th Street at lower volumes, helping to preserve the streetscape for businesses and restaurants. One can only wonder how this section of Nicollet Avenue will change once reconnected to the south.

Looking south on Nicollet Ave from 28th St showing the back of the Kmart store, and planters at the edge of the bridge over the 29th St railroad tracks.
Nicollet Avenue and the back of the Kmart. Credit: Hennepin County Library.

At the time that this stretch of the Midtown Greenway was being constructed in 2000, there were still railroad tracks on the south side of the trench. By adding an access ramp to Nicollet Avenue, this created a pinch point under the bridge where both directions of the bikeway and pedestrians are forced into a narrow path next to the ramp and under the bridge. The entire bikeway in this section of the Midtown Greenway is elevated several feet higher than the original level of the trench.

Looking east on the Midtown Greenway showing the Nicollet Ave bridge in the distance, and a road closed sign blocking access the the ramp from the greenway to Nicollet Ave.
Looking east on the Midtown Greenway with the closed access ramp, narrower path, and a fence separating the path from the lower trench floor. September 19, 2025. Credit: Brian Mitchell.

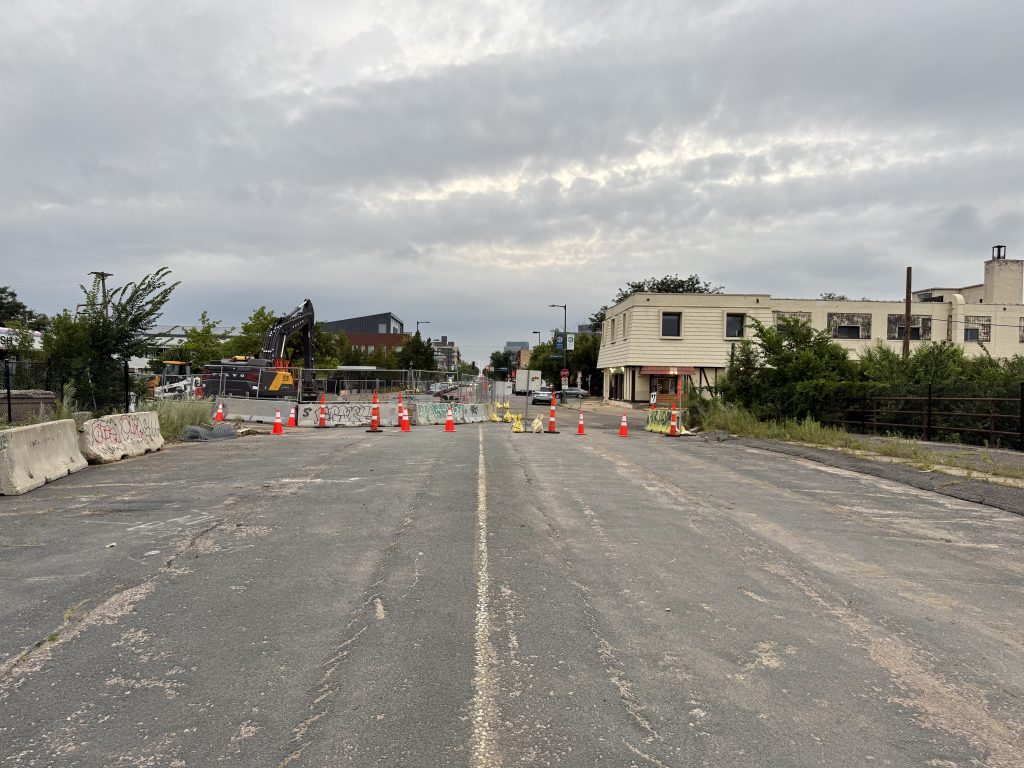

From on top of the Nicollet Ave bridge looking north, the pavement is in poor condition, with linear cracks showing where the streetcar tracks sit underneath.
Looking north from the bridge. Linear cracks in the asphalt show where the streetcar tracks sit underneath. August 14, 2025. Credit: Brian Mitchell.
Standing on the south side of the bridge, vegetation is growing on and around the bridge road pavement. Bumps and cracks in the pavement show signs of settling, and streetcar tracks.
The south end of the bridge, which is showing settling of the land immediately adjacent. The location of the streetcar tracks can be seen based on the linear cracking and bulging of the asphalt. August 14, 2025. Credit: Brian Mitchell.

Demolition

This past June, the demolition of the existing bridge and construction of the new one was included in the city’s Prioritized Bridge Replacement List at a cost of $11,300,000. Demolition preparation started this fall, and the Midtown Greenway was closed beginning October 14 for three weeks for the removal of the bridge and to install a temporary trail.

Advertisement

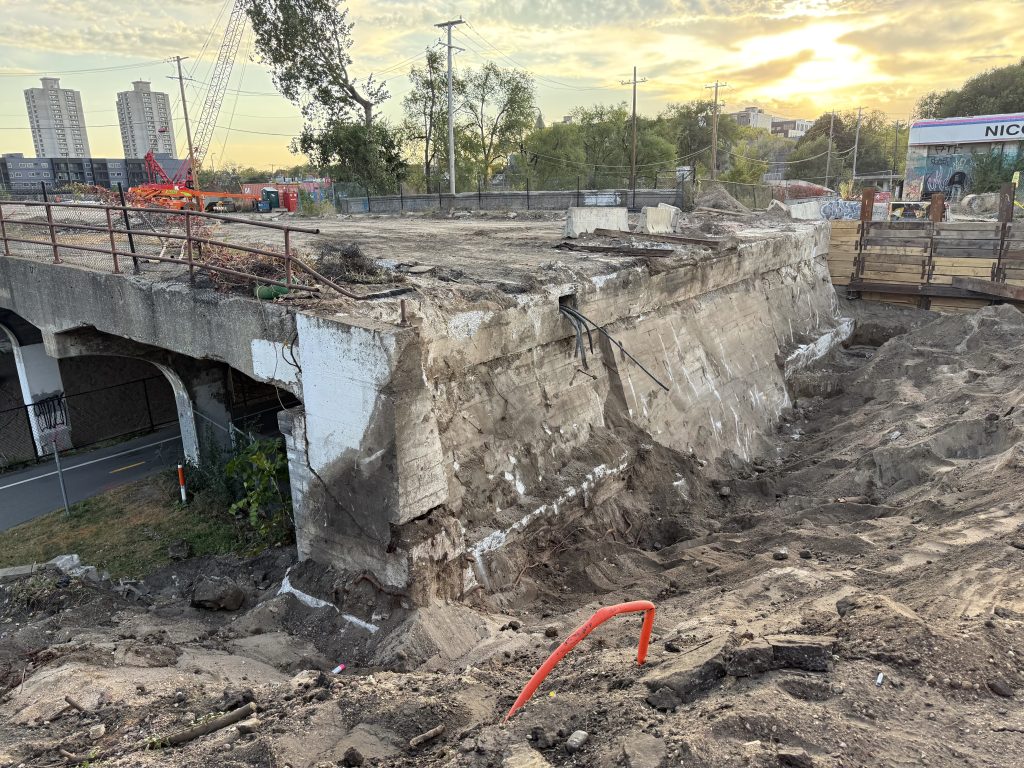

Looking southwest from the northeast corner of the Nicollet Ave bridge, most of the north abutment is exposed, with utilities and cut streetcar rails gaining off the edge.
Preparing to demolish the bridge exposed the north abutment. Note the streetcar rails sitting on the bridge deck, and depression of the deck where the rails were set. October 9, 2025. Credit: Brian Mitchell.
Multiple excavators are working on breaking up the Nicollet Ave bridge, with one sitting on the deck. The east half of the deck has been removed and is a pile of concrete and rebar surrounding the piers that once supported it.
The first day of demolition, October 14, 2025. Credit: Brian Mitchell.

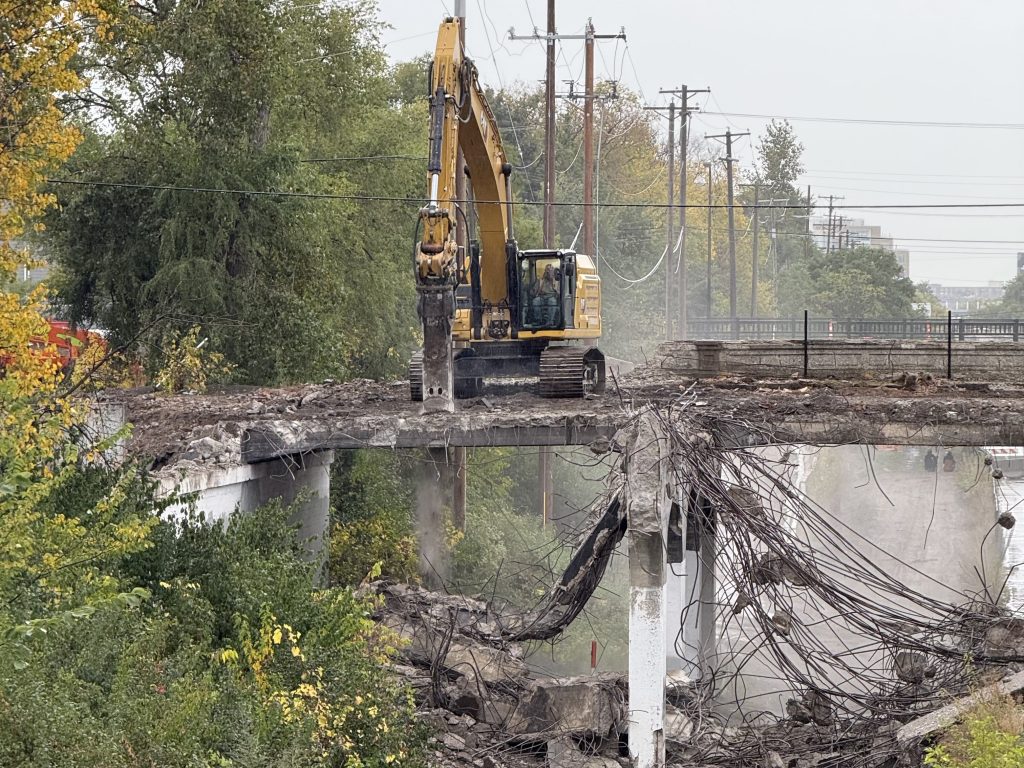

Side profile of the Nicollet Ave bridge looking to the west, an excavator sits on the bridge while breaking up the concrete next to it. Bands of concrete and rebar hang off of the piers.
The first day of demolition, October 14, 2025. Credit: Brian Mitchell.

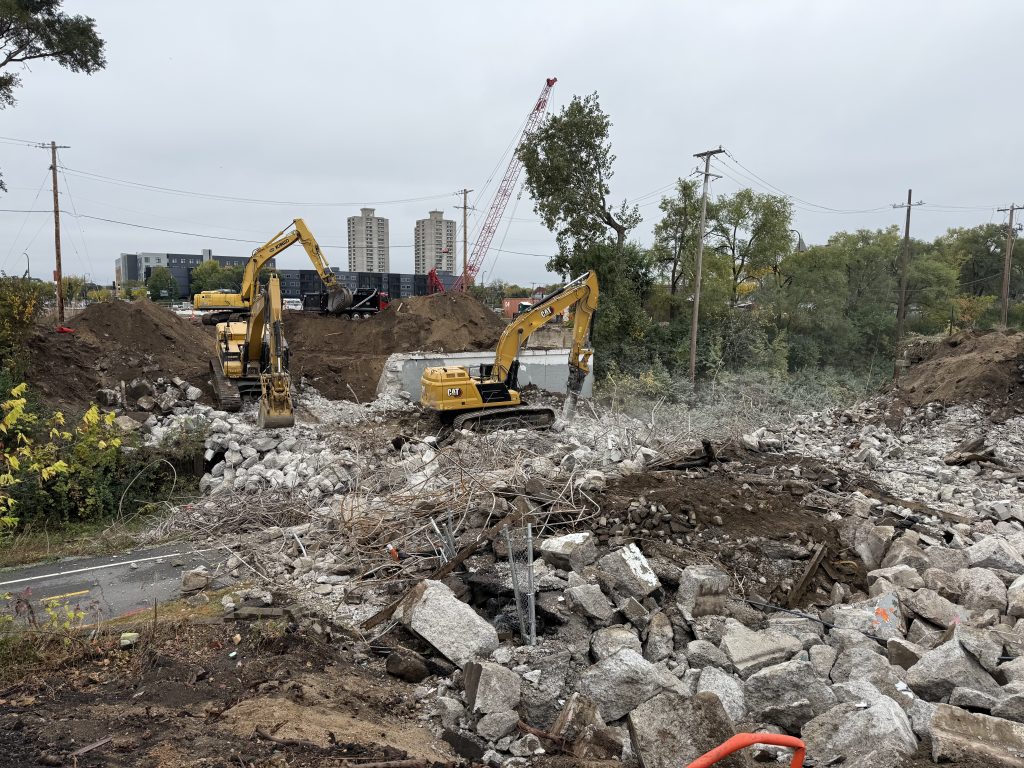

Three excavators work on breaking up, sorting, and moving a large pile of concrete and rebar where the Nicollet Ave bridge once stood. The southern abutment is roughly 60% still intact.
Midday on the second day of demolition, October 15, 2025. Credit: Brian Mitchell.

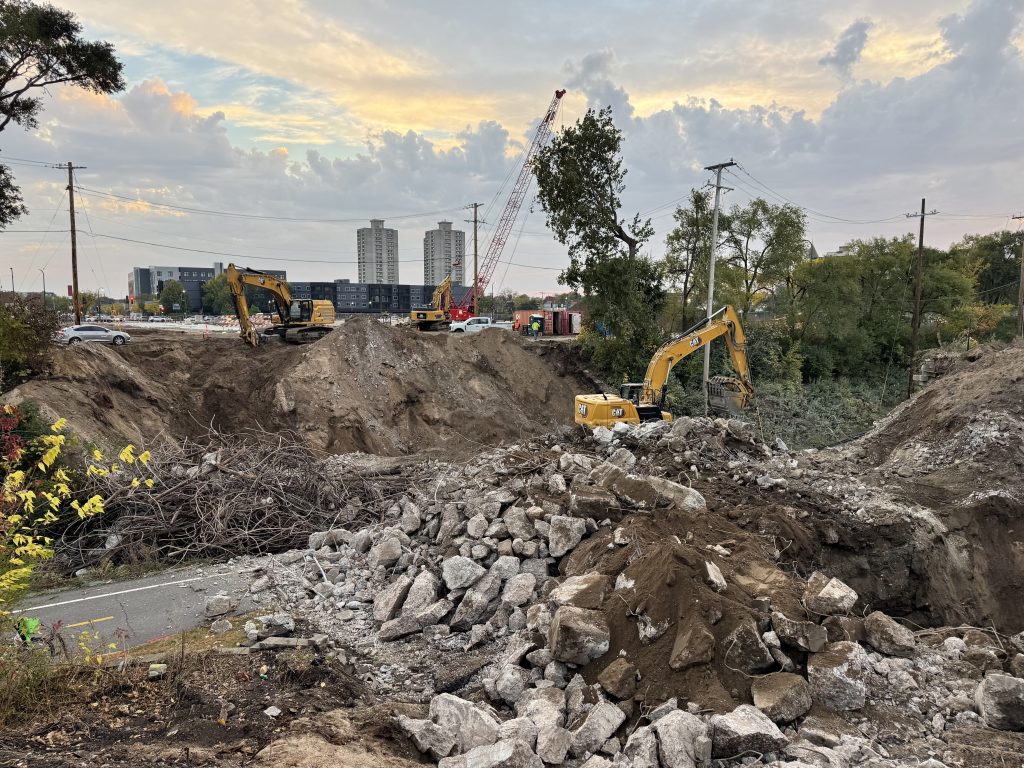

A pile of twisted rebar and some streetcar rail sits next to an even larger pile of concrete and dirt where the Nicollet Ave bridge once stood.
End of the third day of demolition, October 16, 2025. Credit: Brian Mitchell.

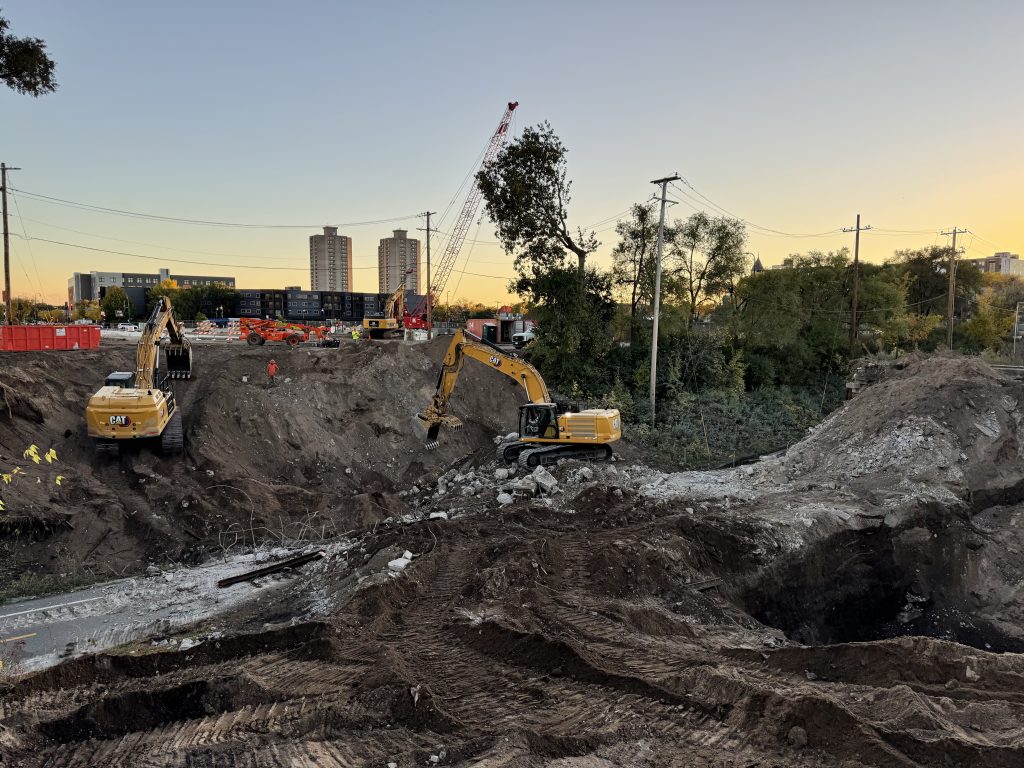

Some concrete, but mostly dirt covers the Midtown Greenway trail where the Nicollet Ave bridge once stood. Three excavators are working and a crane sits in the background.
End of the fourth day of demolition, October 17, 2025. Credit: Brian Mitchell.

The new bridge should be completed in 2026 and until then, the Midtown Greenway will be using a temporary alignment and will likely be closed a few times to accommodate the construction. After construction of the new bridge, a new ramp to access the Midtown Greenway will be installed one block to the east at 1st Avenue connecting the newly reconstructed road and separated two-way bike path.

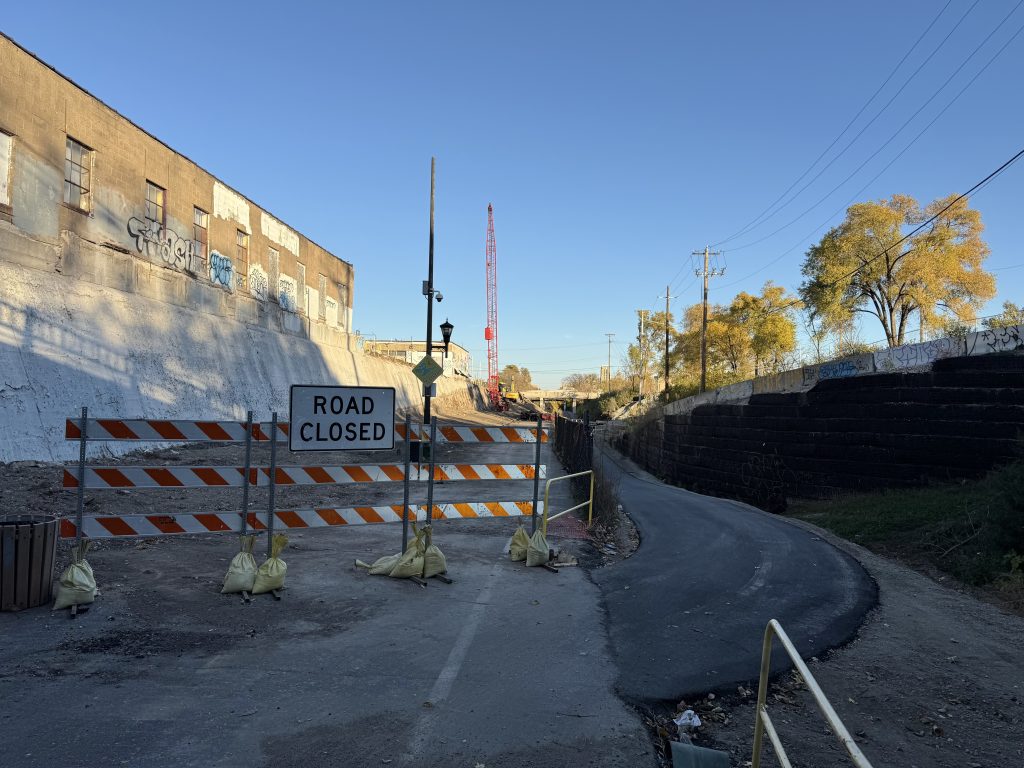

A road closed sign blocks the trail on the Midtown Greenway. A more narrow fresh asphalt path veers off of the trail into the lower utility path of the corridor.
Temporary alignment for the Midtown Greenway, November 5, 2025. Credit: Brian Mitchell.
A crane sits with an attachment for driving piles. Several piles sit in place coming out of the ground, and temporary shoring is installed around the work area. An excavator sits at street level above, and part of the 1910s retaining wall is at the left of the frame.
Construction has started for the new bridge, starting with piles for the foundation. November 15, 2025. Credit: Brian Mitchell.
